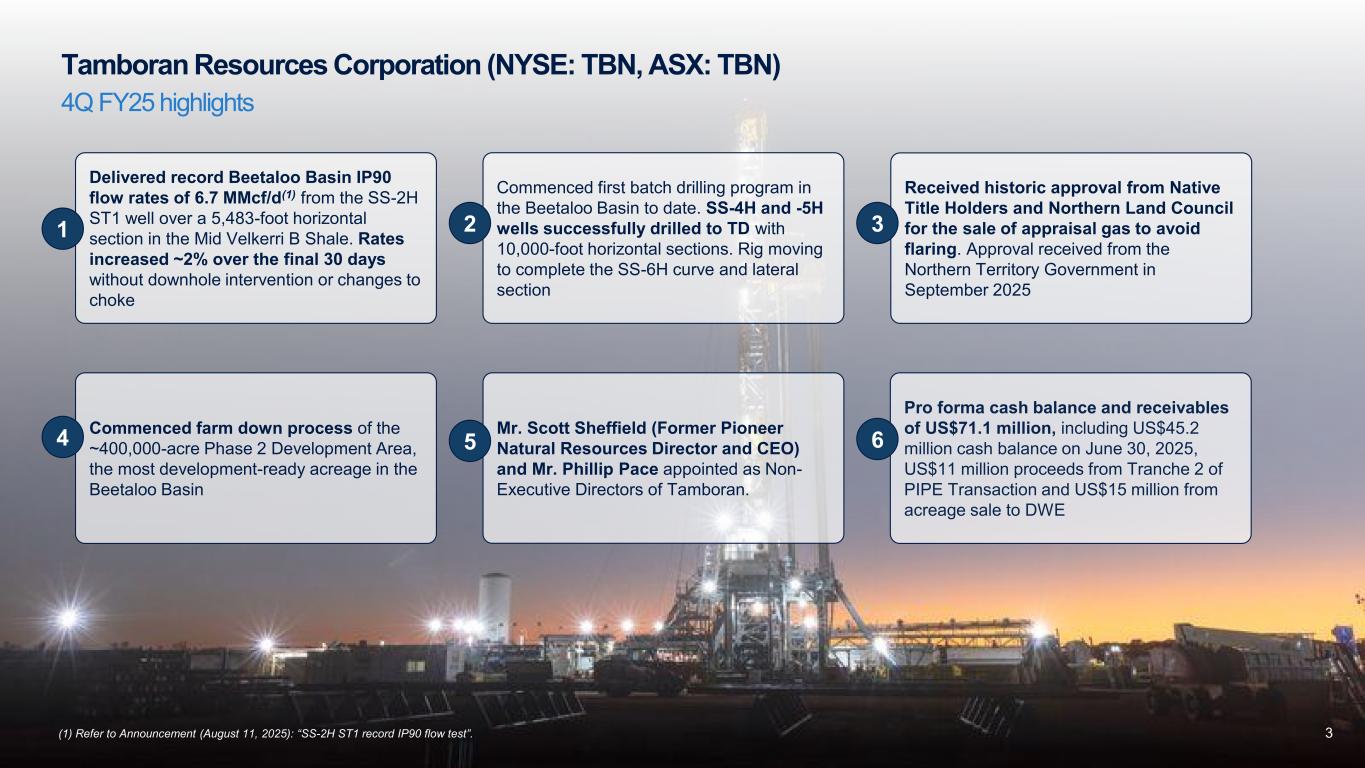

3 Tamboran Resources Corporation (NYSE: TBN, ASX: TBN) 4Q FY25 highlights Delivered record Beetaloo Basin IP90 flow rates of 6.7 MMcf/d(1) from the SS-2H ST1 well over a 5,483-foot horizontal section in the Mid Velkerri B Shale. Rates increased ~2% over the final 30 days without downhole intervention or changes to choke Commenced first batch drilling program in the Beetaloo Basin to date. SS-4H and -5H wells successfully drilled to TD with 10,000-foot horizontal sections. Rig moving to complete the SS-6H curve and lateral section Commenced farm down process of the ~400,000-acre Phase 2 Development Area, the most development-ready acreage in the Beetaloo Basin Received historic approval from Native Title Holders and Northern Land Council for the sale of appraisal gas to avoid flaring. Approval received from the Northern Territory Government in September 2025 Mr. Scott Sheffield (Former Pioneer Natural Resources Director and CEO) and Mr. Phillip Pace appointed as Non- Executive Directors of Tamboran. Pro forma cash balance and receivables of US$71.1 million, including US$45.2 million cash balance on June 30, 2025, US$11 million proceeds from Tranche 2 of PIPE Transaction and US$15 million from acreage sale to DWE 1 2 4 3 5 6 (1) Refer to Announcement (August 11, 2025): “SS-2H ST1 record IP90 flow test”.

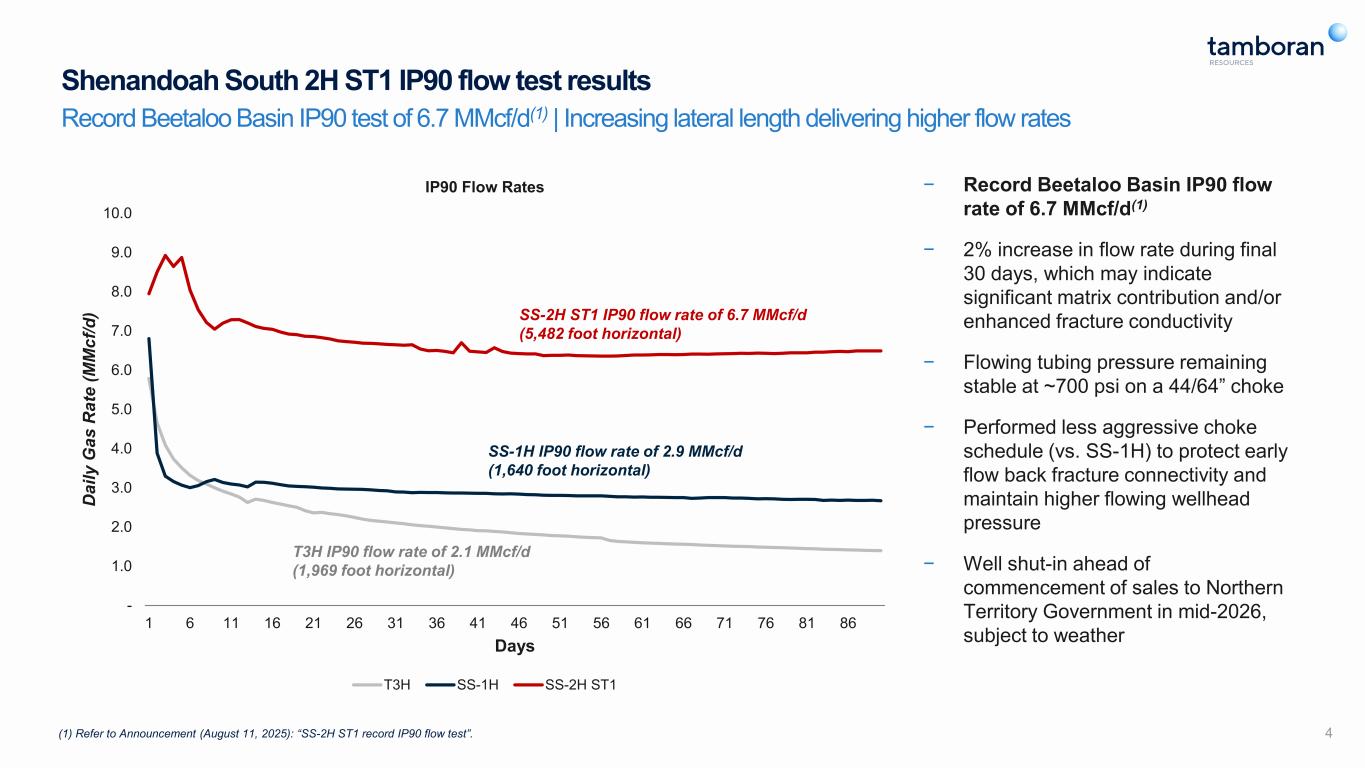

- 1.0 2.0 3.0 4.0 5.0 6.0 7.0 8.0 9.0 10.0 1 6 11 16 21 26 31 36 41 46 51 56 61 66 71 76 81 86 D a il y G a s R a te ( M M c f/ d ) Days IP90 Flow Rates T3H SS-1H SS-2H ST1 − Record Beetaloo Basin IP90 flow rate of 6.7 MMcf/d(1) − 2% increase in flow rate during final 30 days, which may indicate significant matrix contribution and/or enhanced fracture conductivity − Flowing tubing pressure remaining stable at ~700 psi on a 44/64” choke − Performed less aggressive choke schedule (vs. SS-1H) to protect early flow back fracture connectivity and maintain higher flowing wellhead pressure − Well shut-in ahead of commencement of sales to Northern Territory Government in mid-2026, subject to weather 4 Shenandoah South 2H ST1 IP90 flow test results Record Beetaloo Basin IP90 test of 6.7 MMcf/d(1) | Increasing lateral length delivering higher flow rates SS-1H IP90 flow rate of 2.9 MMcf/d (1,640 foot horizontal) SS-2H ST1 IP90 flow rate of 6.7 MMcf/d (5,482 foot horizontal) T3H IP90 flow rate of 2.1 MMcf/d (1,969 foot horizontal) (1) Refer to Announcement (August 11, 2025): “SS-2H ST1 record IP90 flow test”.

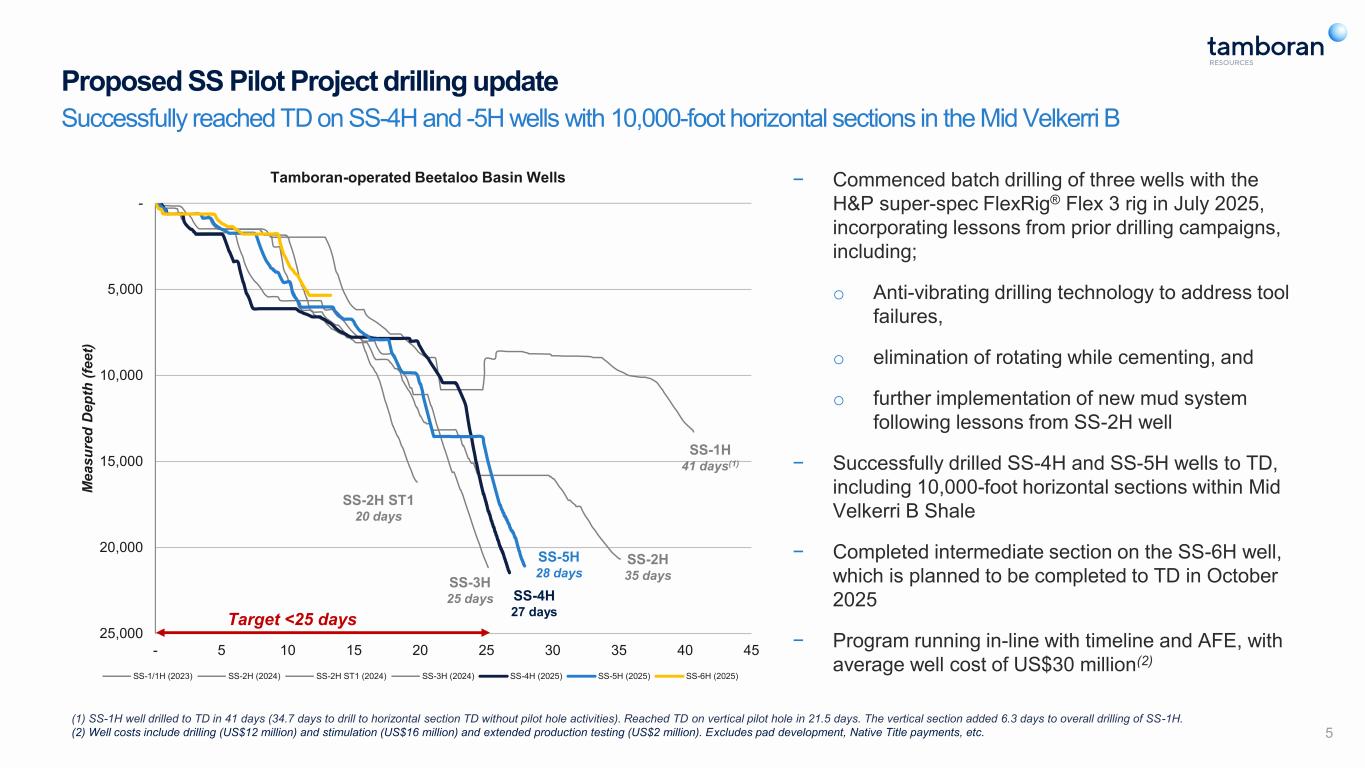

5 Proposed SS Pilot Project drilling update Successfully reached TD on SS-4H and -5H wells with 10,000-foot horizontal sections in the Mid Velkerri B - 5,000 10,000 15,000 20,000 25,000 - 5 10 15 20 25 30 35 40 45 M e a s u re d D e p th ( fe e t) Tamboran-operated Beetaloo Basin Wells SS-1/1H (2023) SS-2H (2024) SS-2H ST1 (2024) SS-3H (2024) SS-4H (2025) SS-5H (2025) SS-6H (2025) SS-2H ST1 20 days − Commenced batch drilling of three wells with the H&P super-spec FlexRig® Flex 3 rig in July 2025, incorporating lessons from prior drilling campaigns, including; o Anti-vibrating drilling technology to address tool failures, o elimination of rotating while cementing, and o further implementation of new mud system following lessons from SS-2H well − Successfully drilled SS-4H and SS-5H wells to TD, including 10,000-foot horizontal sections within Mid Velkerri B Shale − Completed intermediate section on the SS-6H well, which is planned to be completed to TD in October 2025 − Program running in-line with timeline and AFE, with average well cost of US$30 million(2) Target <25 days (1) SS-1H well drilled to TD in 41 days (34.7 days to drill to horizontal section TD without pilot hole activities). Reached TD on vertical pilot hole in 21.5 days. The vertical section added 6.3 days to overall drilling of SS-1H. (2) Well costs include drilling (US$12 million) and stimulation (US$16 million) and extended production testing (US$2 million). Excludes pad development, Native Title payments, etc. SS-3H 25 days SS-2H 35 days SS-1H 41 days(1) SS-5H 28 days SS-4H 27 days

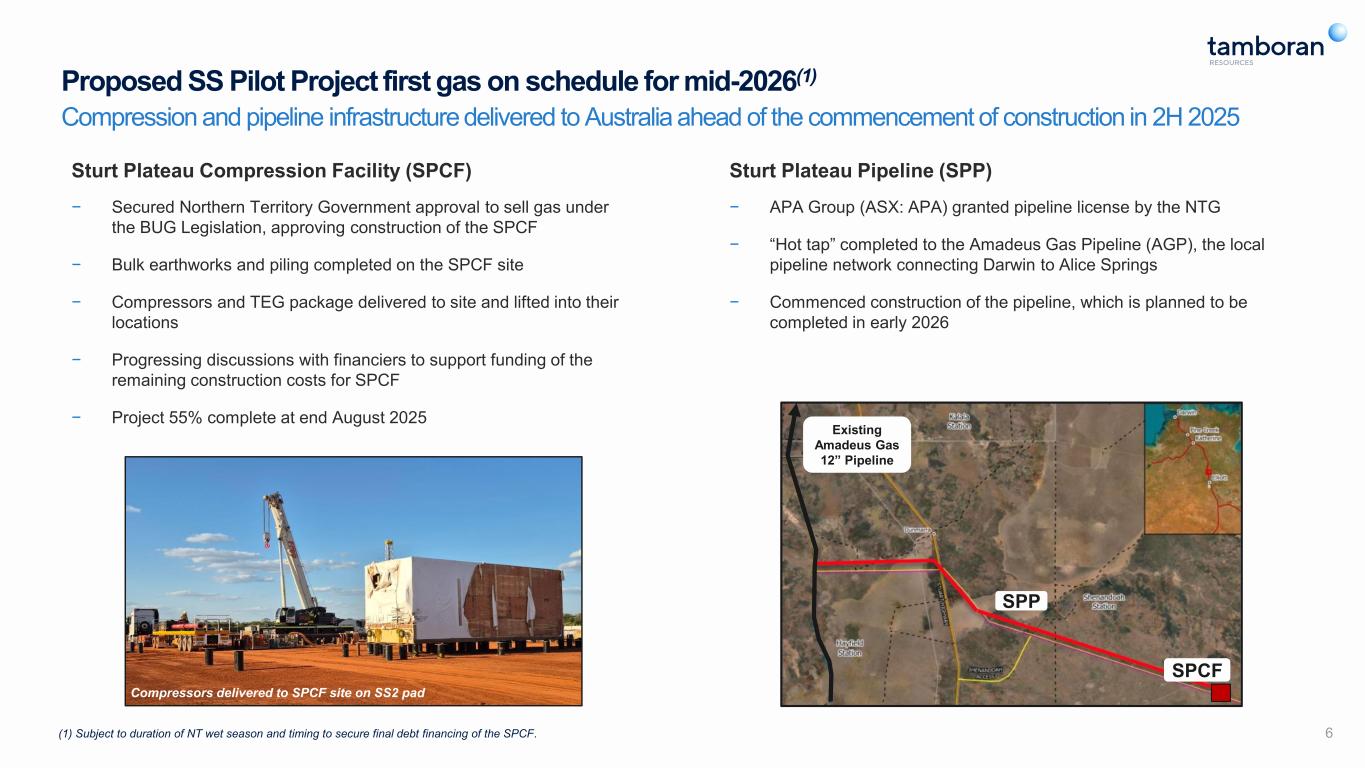

6 Proposed SS Pilot Project first gas on schedule for mid-2026(1) Compression and pipeline infrastructure delivered to Australia ahead of the commencement of construction in 2H 2025 Sturt Plateau Pipeline (SPP) − APA Group (ASX: APA) granted pipeline license by the NTG − “Hot tap” completed to the Amadeus Gas Pipeline (AGP), the local pipeline network connecting Darwin to Alice Springs − Commenced construction of the pipeline, which is planned to be completed in early 2026 Sturt Plateau Compression Facility (SPCF) − Secured Northern Territory Government approval to sell gas under the BUG Legislation, approving construction of the SPCF − Bulk earthworks and piling completed on the SPCF site − Compressors and TEG package delivered to site and lifted into their locations − Progressing discussions with financiers to support funding of the remaining construction costs for SPCF − Project 55% complete at end August 2025 Compressors delivered to SPCF site on SS2 pad SPP SPCF Existing Amadeus Gas 12” Pipeline (1) Subject to duration of NT wet season and timing to secure final debt financing of the SPCF.

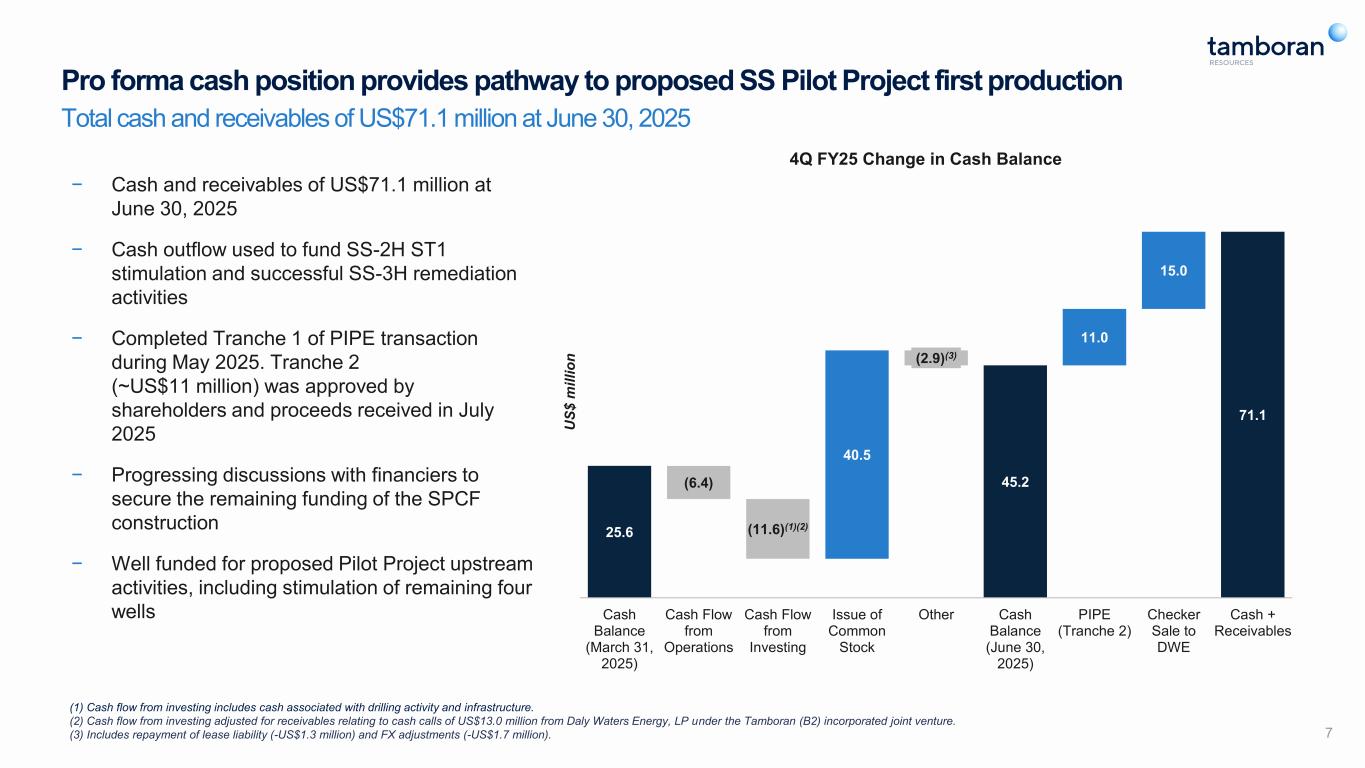

Pro forma cash position provides pathway to proposed SS Pilot Project first production 7 (1) Cash flow from investing includes cash associated with drilling activity and infrastructure. (2) Cash flow from investing adjusted for receivables relating to cash calls of US$13.0 million from Daly Waters Energy, LP under the Tamboran (B2) incorporated joint venture. (3) Includes repayment of lease liability (-US$1.3 million) and FX adjustments (-US$1.7 million). Total cash and receivables of US$71.1 million at June 30, 2025 45.2 71.1 (6.4) (11.6)(1)(2) (2.9)(3) 25.6 40.5 11.0 15.0 Cash Balance (March 31, 2025) Cash Flow from Operations Cash Flow from Investing Issue of Common Stock Other Cash Balance (June 30, 2025) PIPE (Tranche 2) Checker Sale to DWE Cash + Receivables U S $ m il li o n 4Q FY25 Change in Cash Balance − Cash and receivables of US$71.1 million at June 30, 2025 − Cash outflow used to fund SS-2H ST1 stimulation and successful SS-3H remediation activities − Completed Tranche 1 of PIPE transaction during May 2025. Tranche 2 (~US$11 million) was approved by shareholders and proceeds received in July 2025 − Progressing discussions with financiers to secure the remaining funding of the SPCF construction − Well funded for proposed Pilot Project upstream activities, including stimulation of remaining four wells

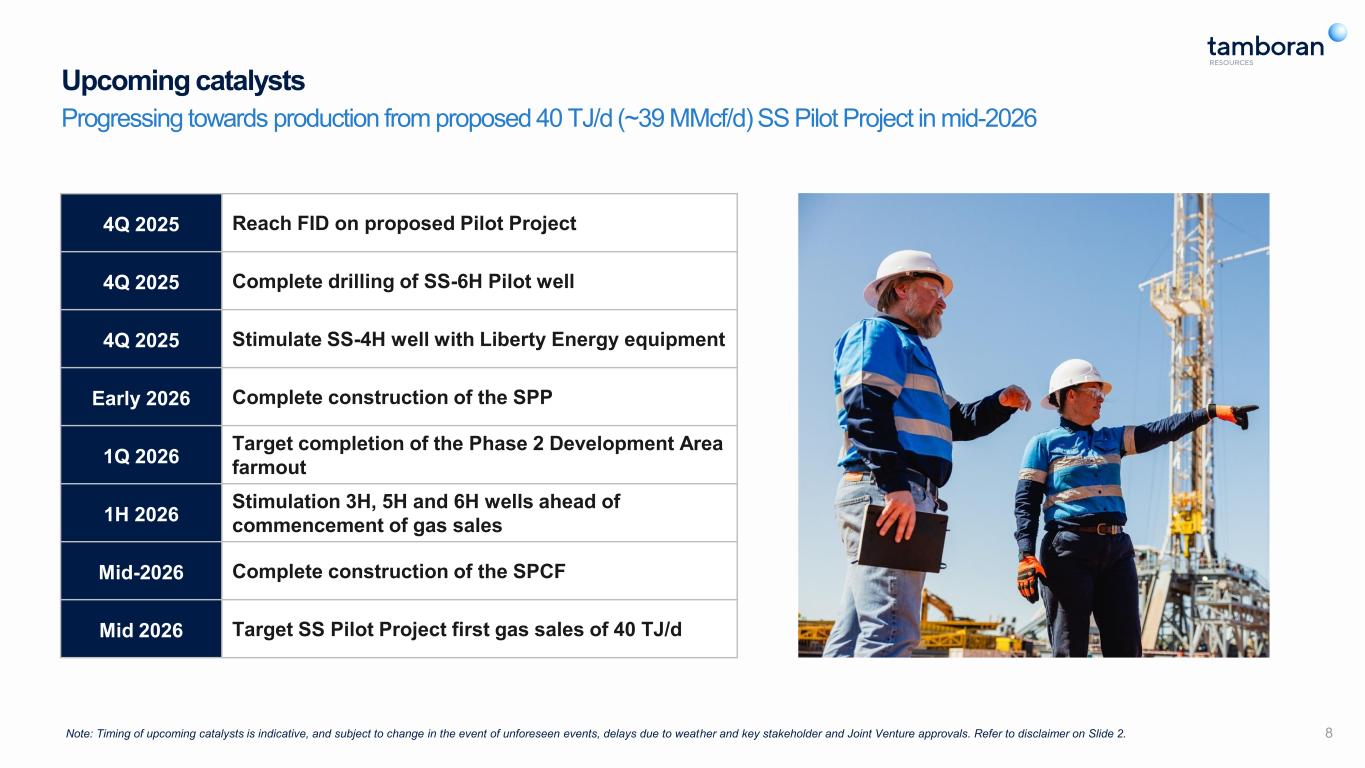

Upcoming catalysts Progressing towards production from proposed 40 TJ/d (~39 MMcf/d) SS Pilot Project in mid-2026 8Note: Timing of upcoming catalysts is indicative, and subject to change in the event of unforeseen events, delays due to weather and key stakeholder and Joint Venture approvals. Refer to disclaimer on Slide 2. 4Q 2025 Reach FID on proposed Pilot Project 4Q 2025 Complete drilling of SS-6H Pilot well 4Q 2025 Stimulate SS-4H well with Liberty Energy equipment Early 2026 Complete construction of the SPP 1Q 2026 Target completion of the Phase 2 Development Area farmout 1H 2026 Stimulation 3H, 5H and 6H wells ahead of commencement of gas sales Mid-2026 Complete construction of the SPCF Mid 2026 Target SS Pilot Project first gas sales of 40 TJ/d
